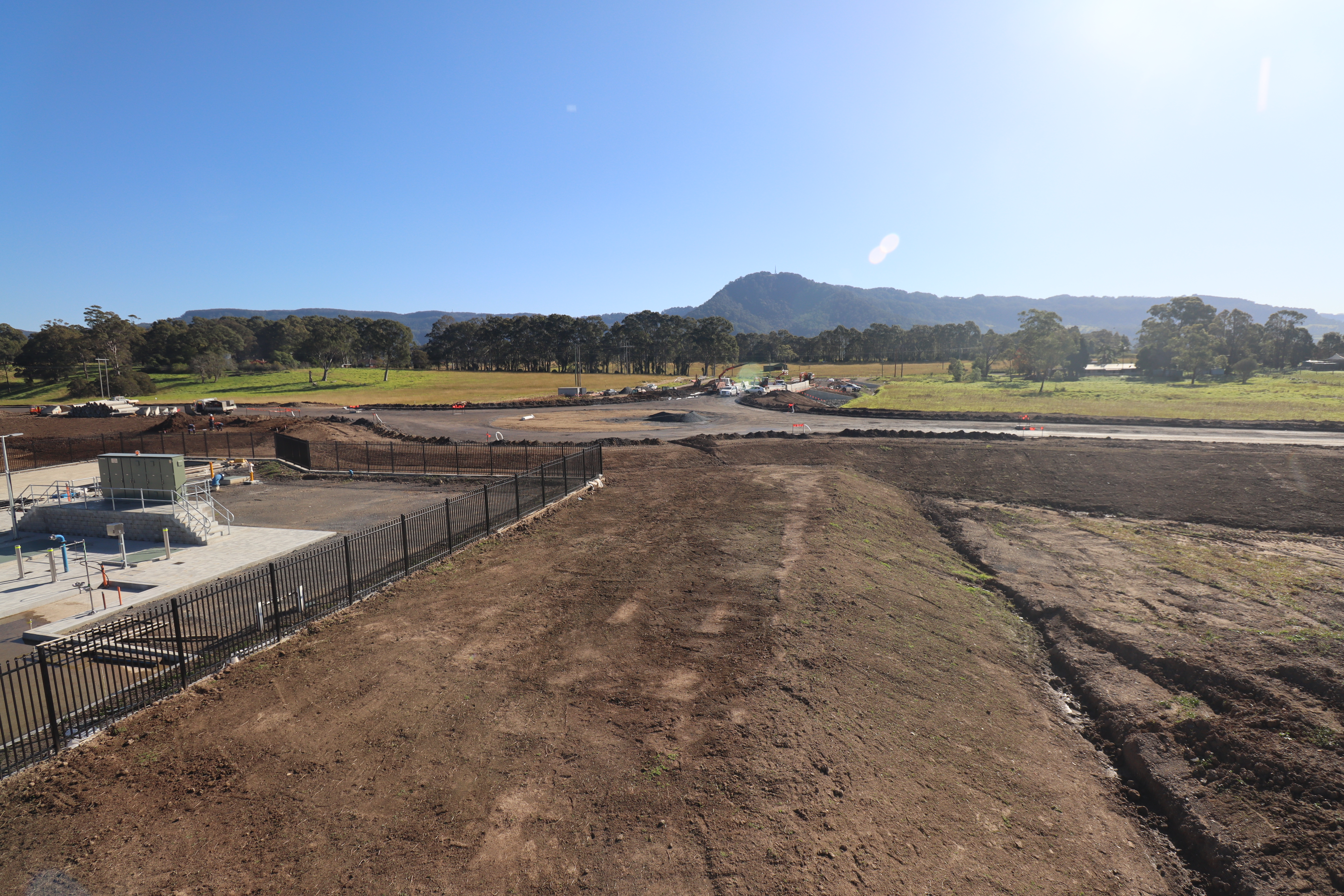

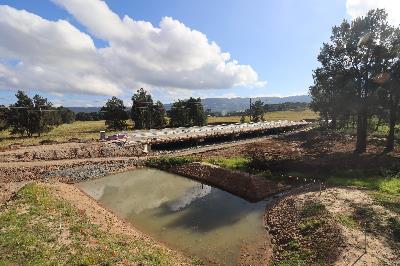

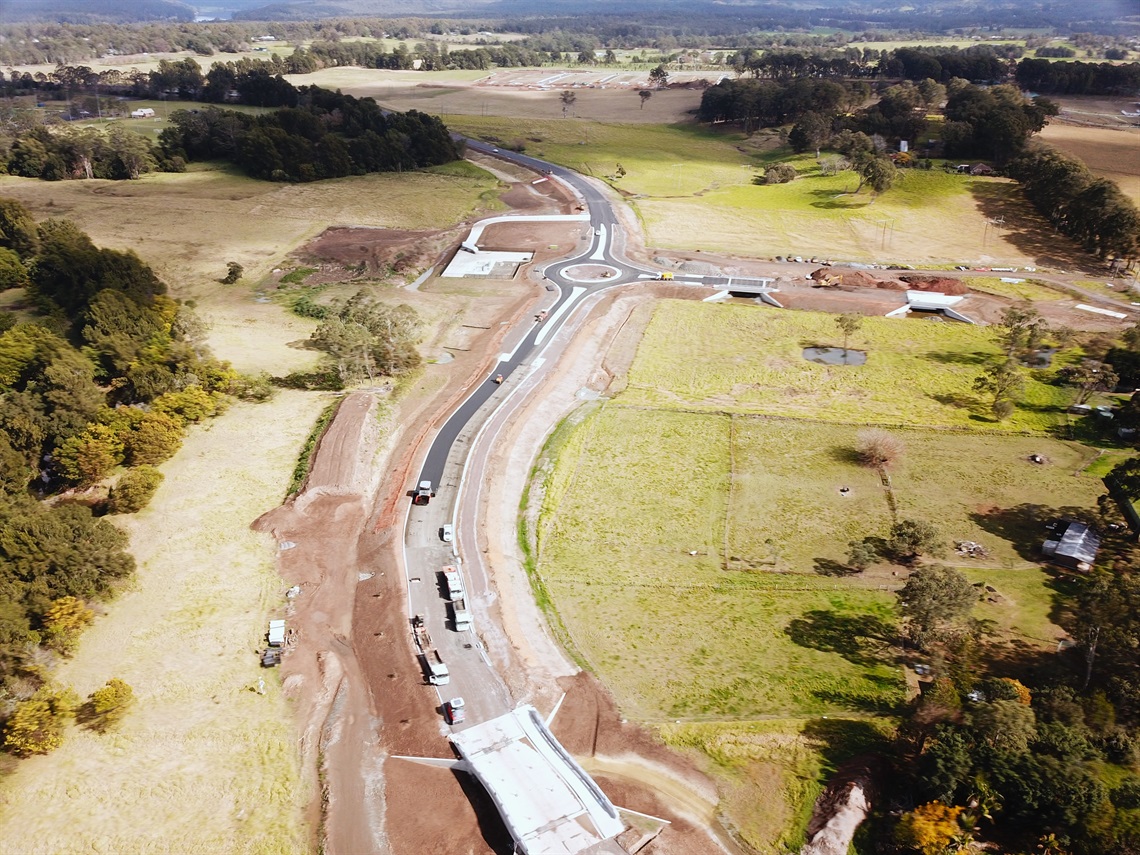

April 2023 - Works commenced on a new roundabout that will form the connection for the FNCR network to Moss Vale Road. Construction of the new roundabout will take approximately 6 months, weather permitting.

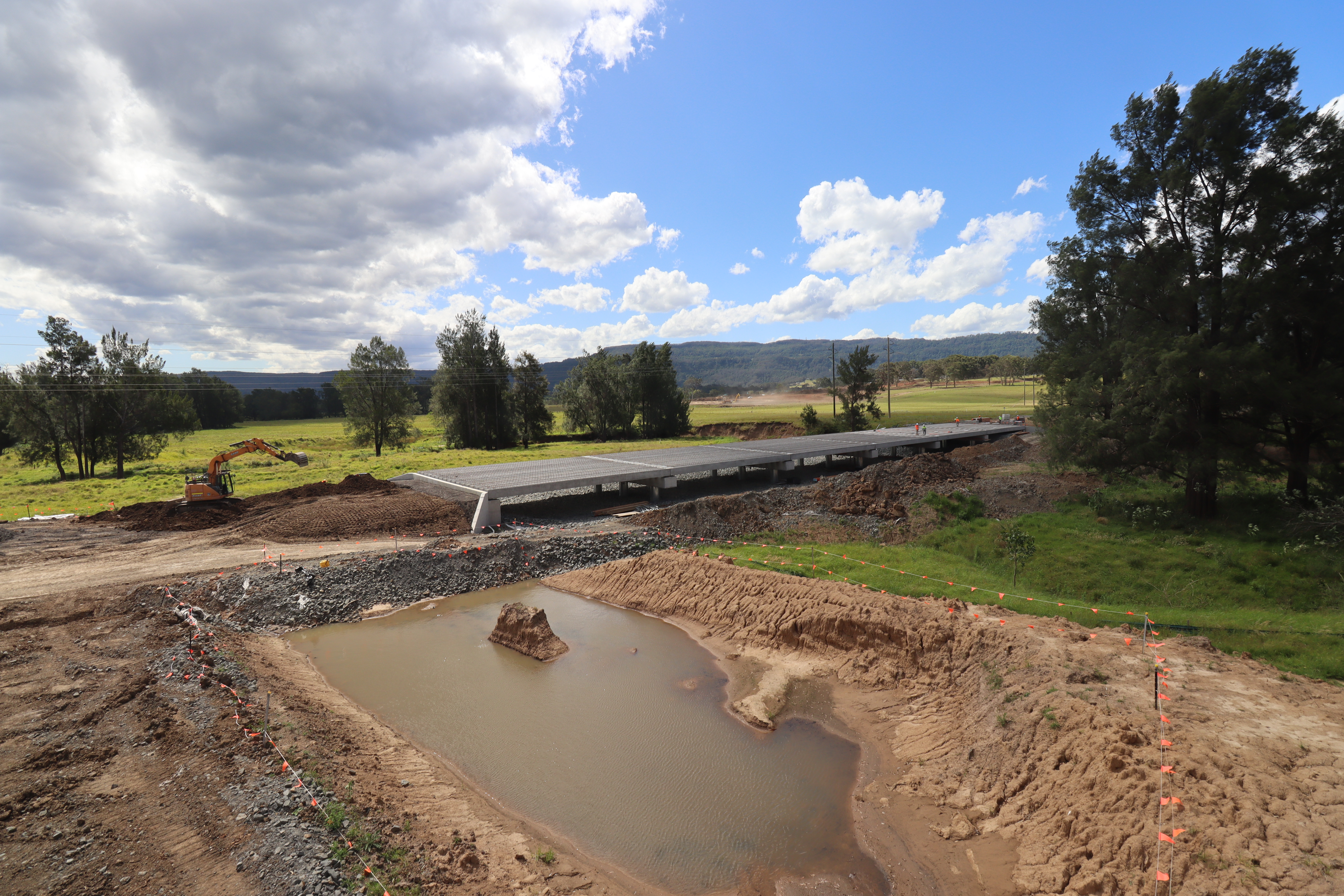

Feb 2023 - Works are progressing well and Cleary Bros will soon start work to construct the roundabout on Moss Vale Road (intersection of Bells Lane and Moss Vale Road). Barriers and reduced speed limits will be in place.

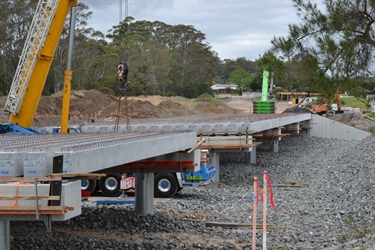

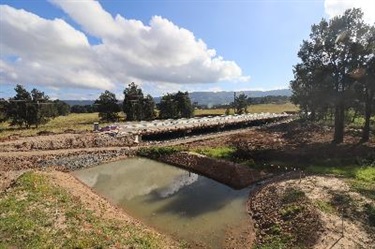

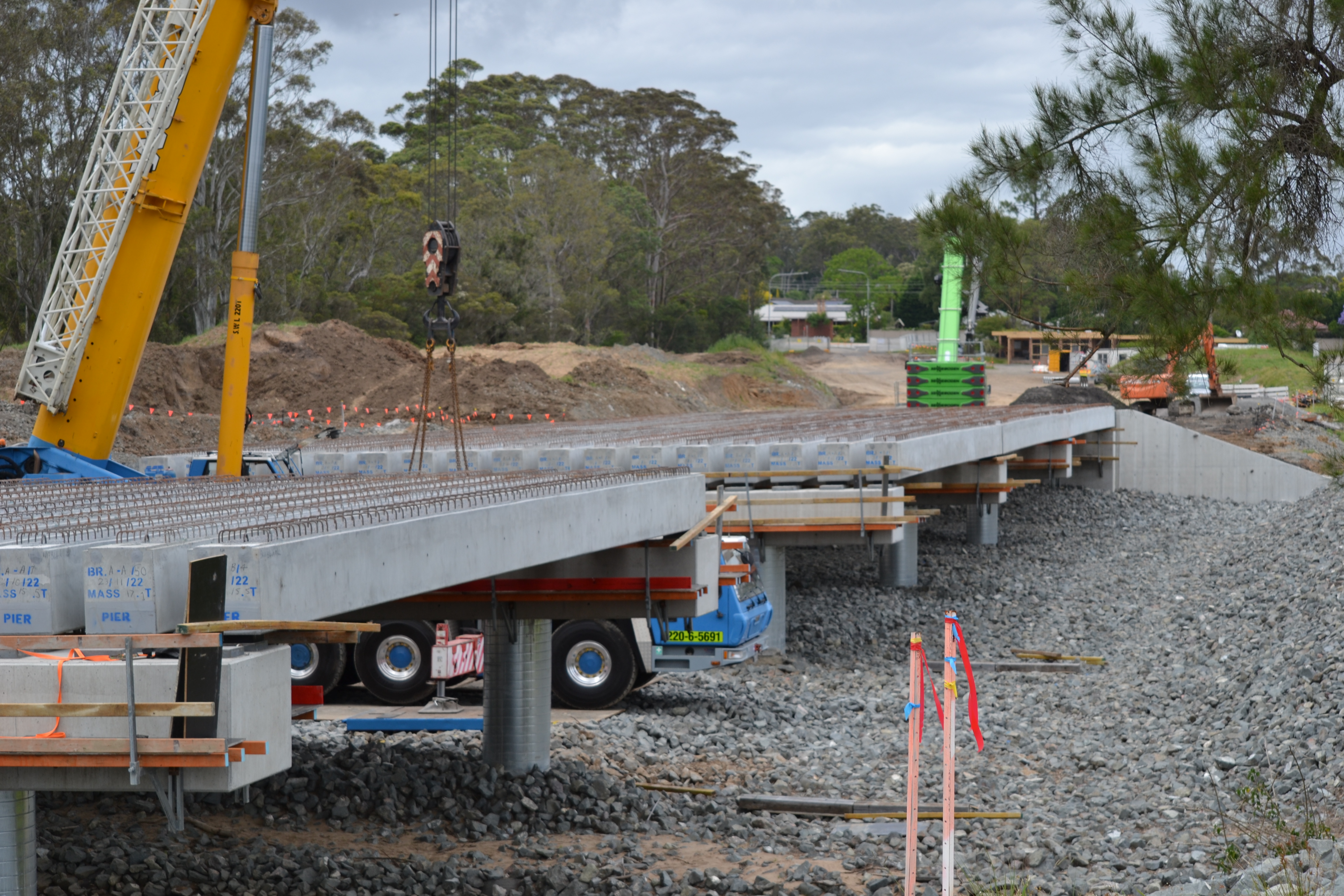

December 2022 - From mid-December, the bridge beams are in place over Bomaderry Creek which spans 110 metres and major earthworks are complete. Stormwater components are being installed. The remaining three bridges will be assembled over the coming month. Preparation works are currently underway for the Moss Vale Road roundabout.

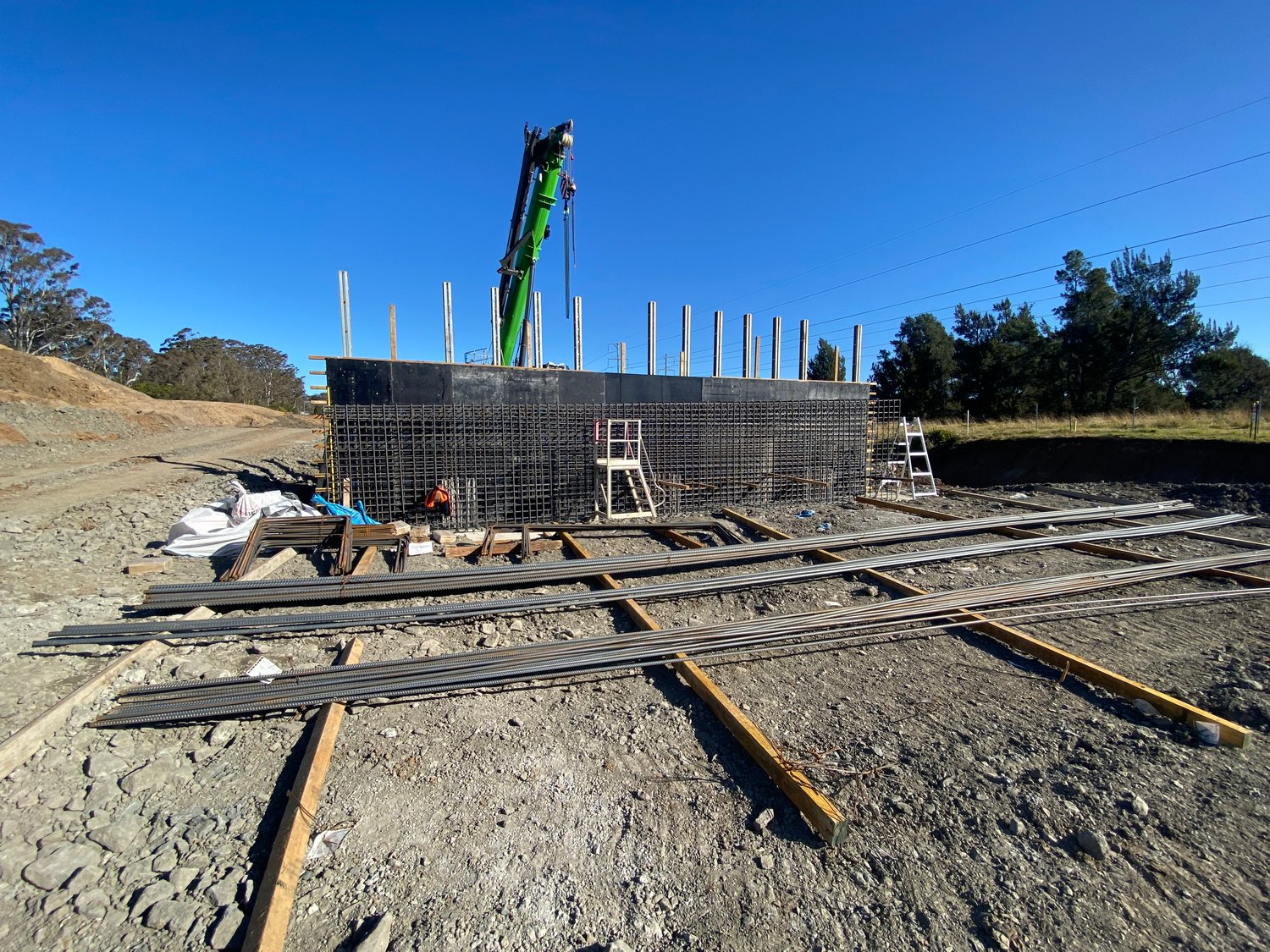

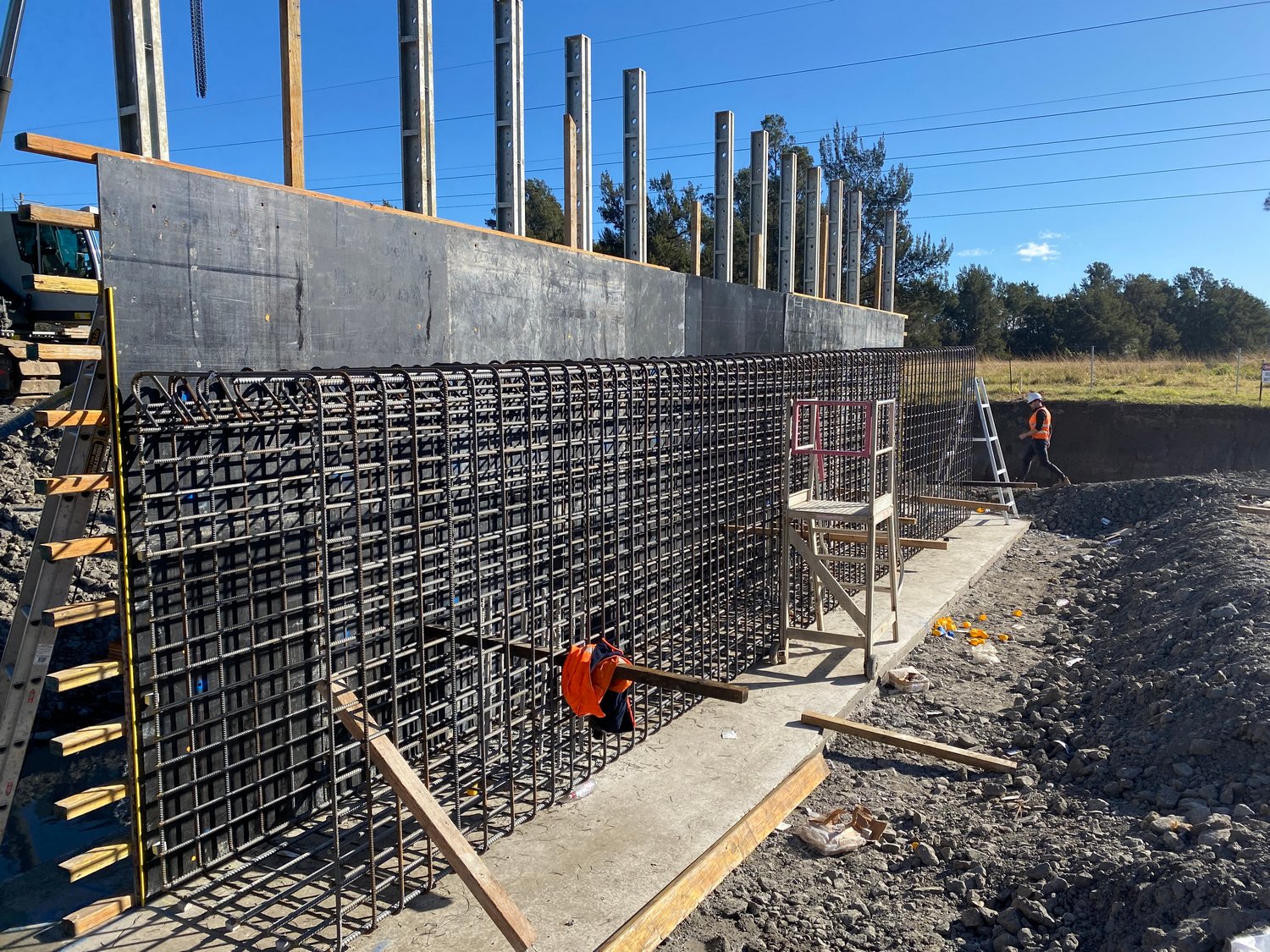

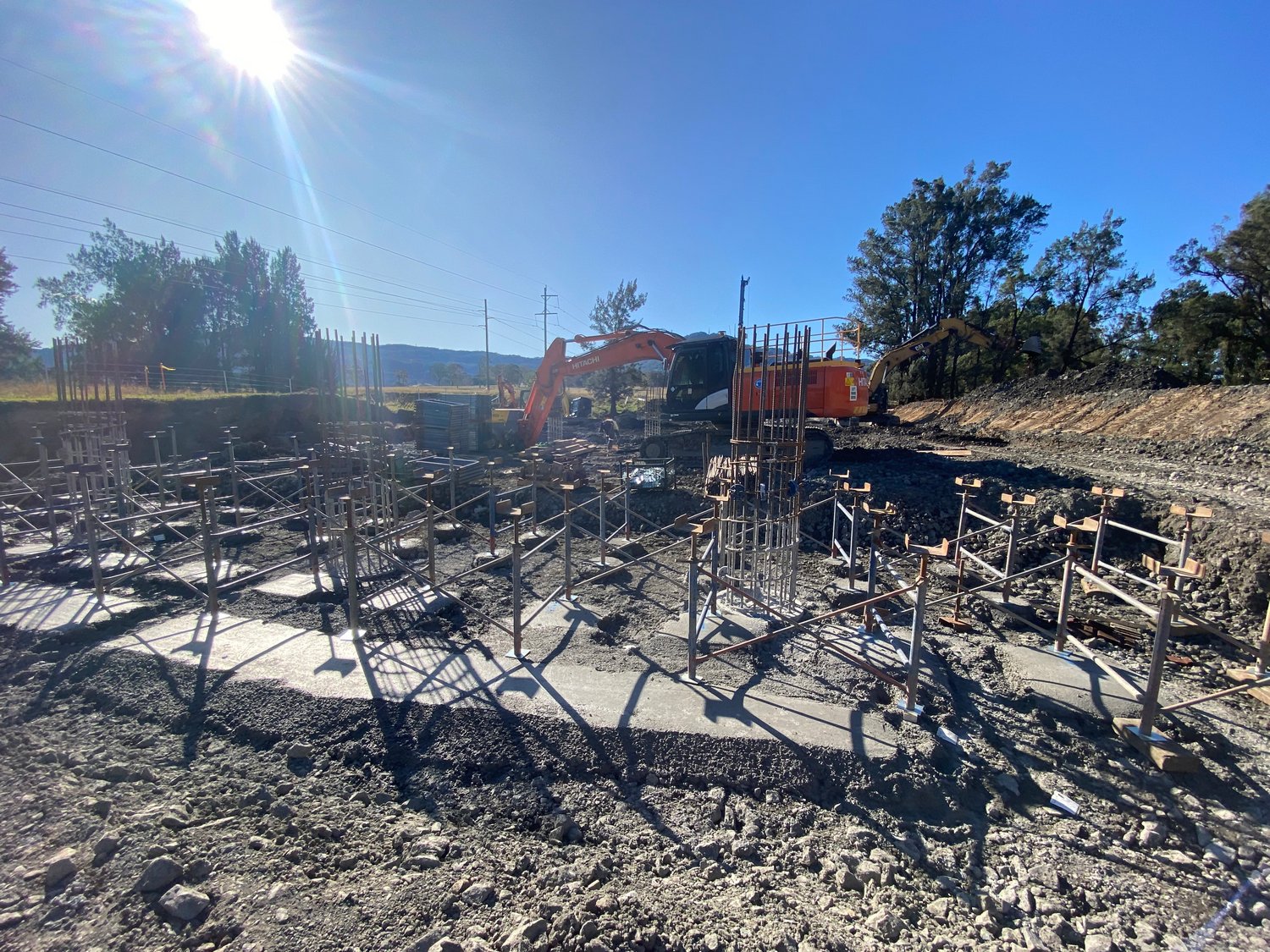

September 2022 - The foundations for all four new bridges are in place, including the 108 m bridge over Bomaderry Creek and floodplain. Concrete bored piles have been installed into high strength rock to create the support for the new structures.
