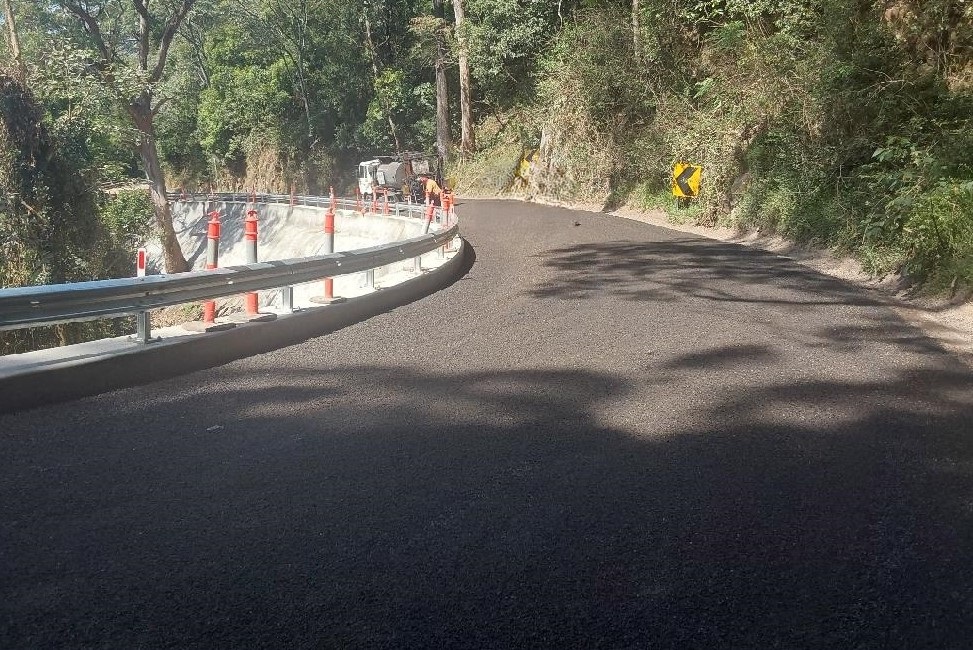

15/11/2024 - Line marking and minor work are planned to be carried out next Thursday 21 November, weather permitting. Landslip reconstruction works are completed.

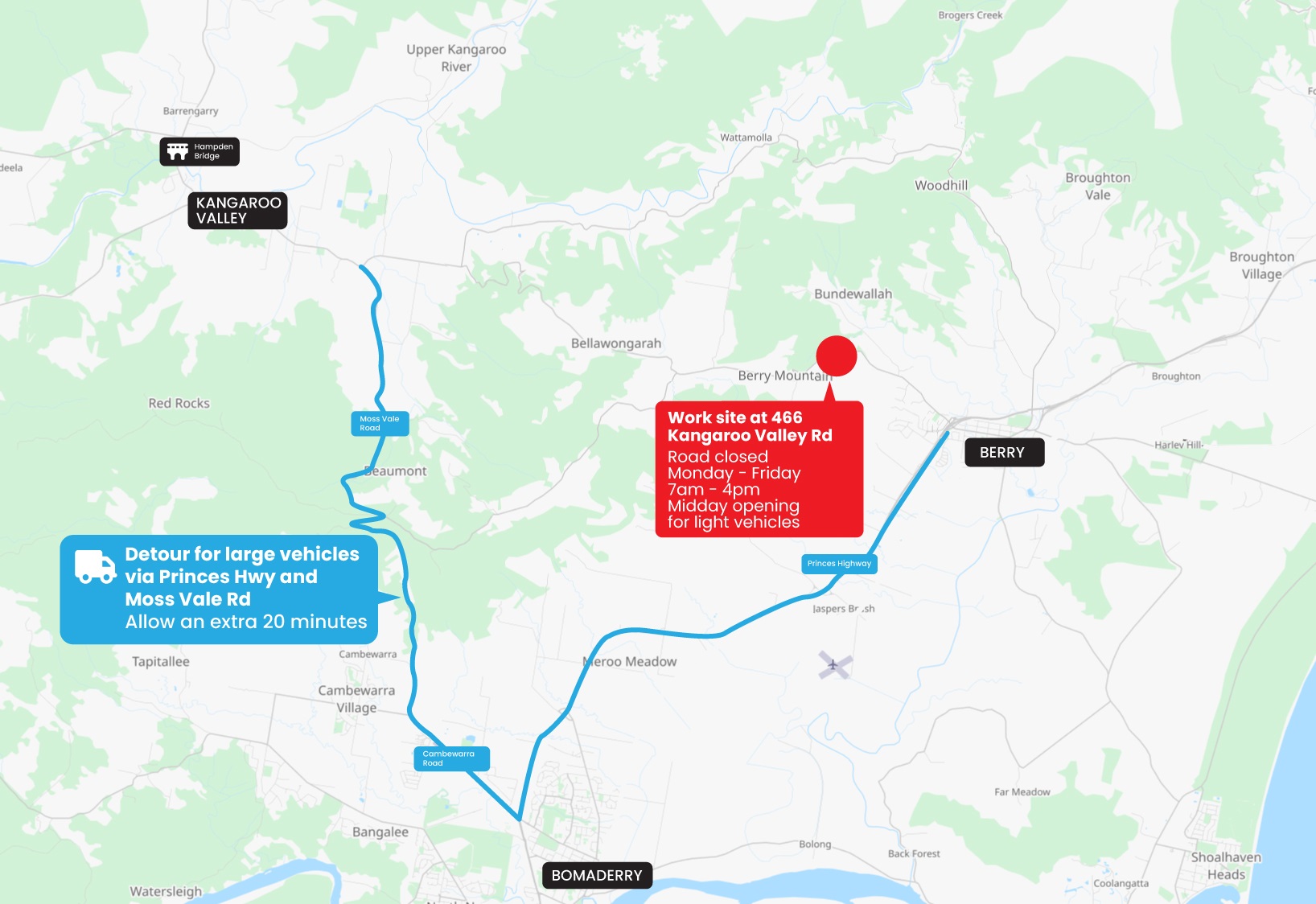

7/11/2024 - With significant damage on Wattamolla Rd following 7 June 2024 rain event, motorists are advised to detour via Moss Vale Rd. See detour map below. Resident access only between Ben Dooley Rd and Bundewallah Rd during works hours, via relevant side of the work site - no access through the site. See detour map below.
7/11/2024 - About the works: Closures ongoing to Monday 11 November 2024, Monday to Fridays 7am to 4pm. Midday opening for waiting traffic 12pm sharp. Contraflow traffic conditions during evenings and weekends. See detour map above for alternative routes. The road will open under contraflow traffic conditions during evenings and weekends.
Works: Road seal is done to be followed by boxout of swale and ready site for asphalt works. Finishing off works will be carried out next Tuesday 12 November and Wednesday 13 November 2024, weather permitting. Traffic control will be removed, and the road will open.
Access: access through the repair site is available to light vehicles only - manual and electric push bikes (bicycles) may also pass through the site at scheduled opening times, including midday opening 12pm sharp. Vehicles greater than 5m in length are required to use the sign posted detour.
Site 1 repair works nearing completion 6 November 2024
10/7/2024 - Temporary Closure: Closures are ongoing to Monday 18 November 2024, Monday to Fridays 7am to 4pm. Midday opening for waiting traffic 12pm sharp. Contraflow conditions evenings and weekends. Find revised detour map under - The latest. For more details see - About the works. Subscribe to this page for updates.
13/6/2024 - Temporary Closure: Planned closures start from Monday 24 June to 18 November 2024, Monday to Fridays 7am to 4pm. Midday opening for waiting traffic 12pm sharp. Contraflow traffic conditions during evenings and weekends. Find detour map under - The latest.
5/6/2024 - Temporary Closure: Due to urgent works needed to stabilise a section of Kangaroo Valley Road, the road will be closed from Monday 24 June, 7am to 4pm Monday to Fridays. Contraflow conditions during evenings and weekends. See Detour map on this page. Find Kangaroo Valley Road Emergency Management Plan under Related Documents. Subscribe to this page for updates.
22/5/2024 - Announcement: Kangaroo Valley Road is now open and under traffic control, with one lane open to motorists. Motorists are advised to allow an extra 5-10 minutes when travelling. Find more details under - About the works.
22/5/2024 - Two (2) major landslips (AGRN 1012) and related repair works were completed March 2024.
18/4/2024 - Announcement: Kangaroo Valley Road is now open and under traffic control, with one lane open to motorists. The road was closed 4pm Saturday 6 April after severe rainfall threatened the stability of a section of road as well as 2 new landslip damages. Motorists using Kangaroo Valley Road are advised to allow an extra 5 – 10 minutes when travelling. 12-tonne load limit. Find more details under - About the works.
New damage: Site 1 near rural address 446 landslip damage 7 April 2024
Kangaroo Valley Road reopened
Kangaroo Valley Road is now open and under traffic control, with one lane open to motorists following declared natural disaster 7 April 2024 (AGRN 1119) severe weather and flooding event.

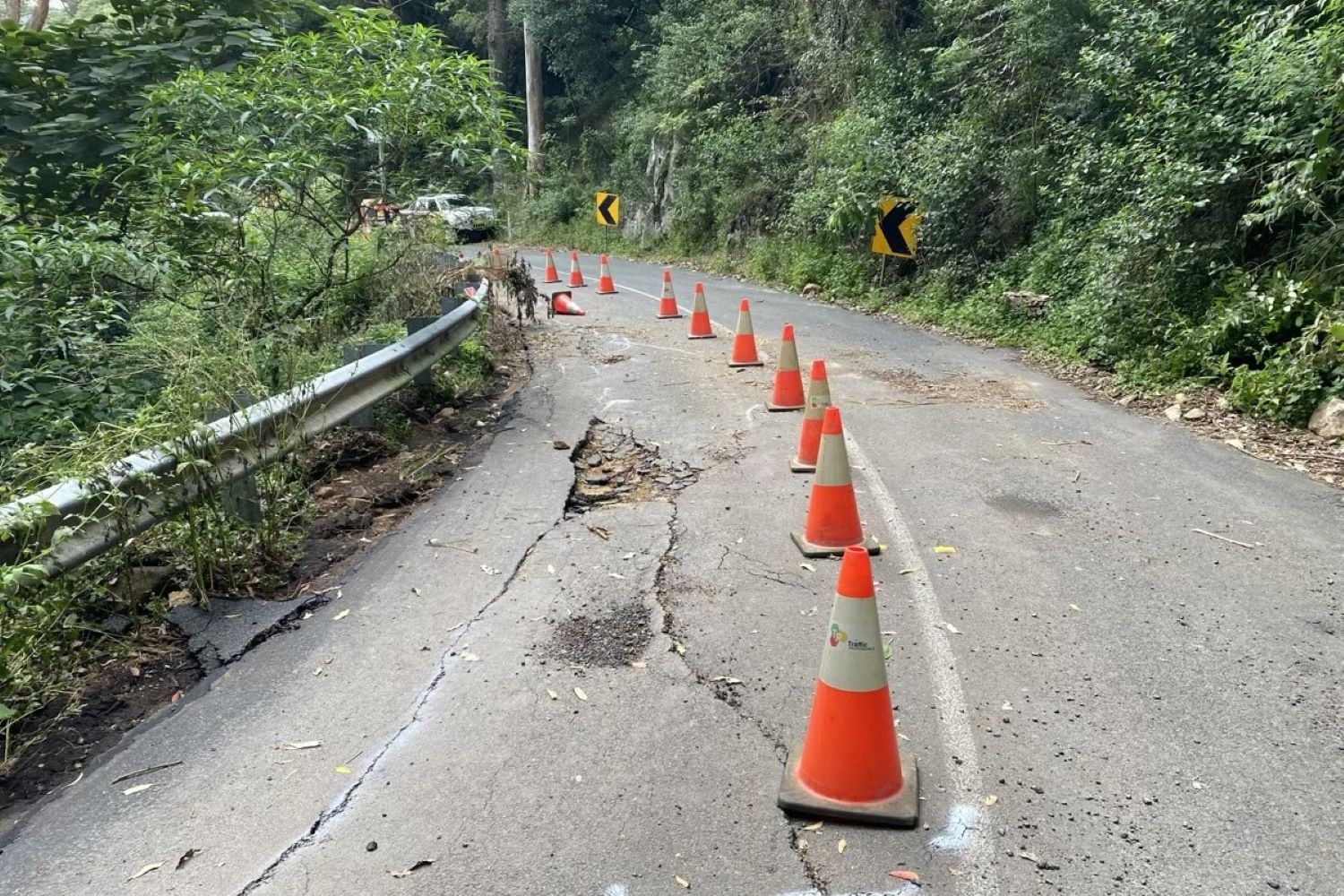

The road was closed 4pm Saturday 6 April 2024 after severe rainfall threatened the stability of a section of the road. The impacted area is approximately 700 metres from the intersection of Ben Dooley Road toward Berry and showing significant cracking and signs of failure. Following a geotechnical investigation, Council has been advised to open one lane while further assessments are continuing. Motorists using Kangaroo Valley Road are advised to allow an extra 5 – 10 minutes when travelling.
Landslip repair sites (AGRN 1012)
Site 1 DM00806 rural address 1260 & Site 2 DM00805 rural address 1167 landslips completed

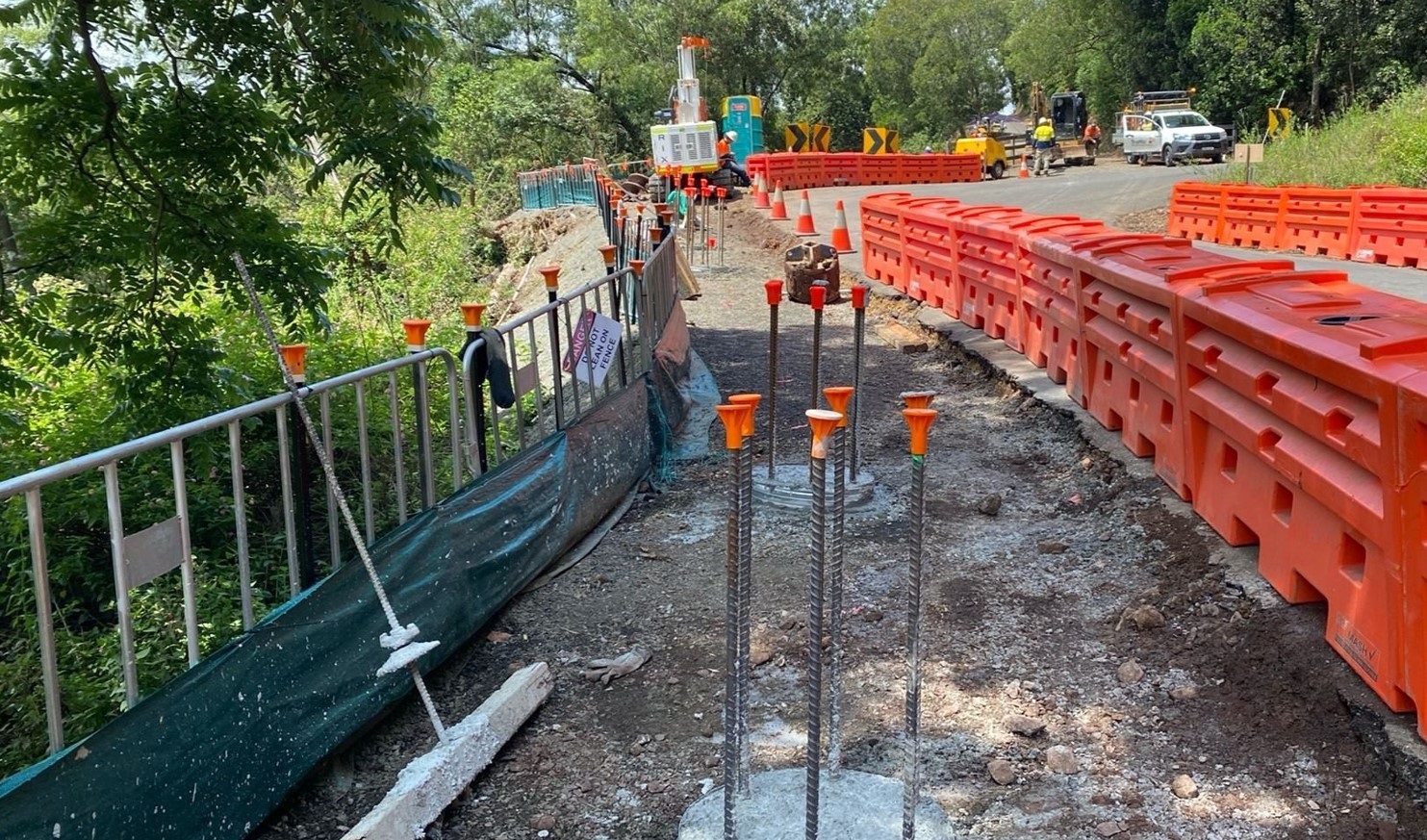

12/3/2024 - Announcement: Contraflow traffic conditions ongoing. All remaining landslip repair works are planned to be completed under contraflow traffic conditions. Guardrail (crash barrier) installation is planned for March 2024. Find details under - About the works. Subscribe to this page for updates.
27/2/2024 - Announcement: Rescheduled completion of landslip repair works at Site 2 is Monday 26 February 2024, weather permitting. The latest: Contractor Symal released revised construction program. Find the updated three-week Lookahead Program 27 February 2024 under Related Documents. Repair works and road closures at each site are also detailed under 'About the works'.
20/2/2024 - Announcement: Planned completion of works at Site 2 is 16 February 2024, weather permitting. Intermittent full road closures at Site 2 near rural address 1167 between 9am and 1.30pm 15 February and 16 February 2024. Expect 30min delays. Otherwise, single lane contraflow traffic conditions. No pedestrian access.
2/1/7/2024 to 23/2/2024 – Updated three-week Lookahead program released each week by contractor, Symal, and published weekly on this page under ‘Related Documents’. Repair works and road closures detailed weekly for all sites under ‘About the works’.
